Populist movements don't build themselves ...

... It doesn't matter what the "horse race" outcome of the campaign is, if we fight the campaign. Fighting it, we learn how to fight. Learning how to fight political battles, we become citizens again. Becoming citizens again, we reclaim the Republic that lies dormant beneath the bread and circuses of modern American society.

Monday, March 30, 2009

Friday, March 27, 2009

An HSR Station Grows at Transbay (SF) (pt 2)

Burning the Midnight Oil for Living Energy Independence

crossposts: Docudharma, ProgressiveBlue, The European Tribune

This is "part 2" of A Train Station Grows at Transbay ... Hopefully not a Bonsai (pt. 1)

In Part 1, an effort was made to try to fit 8 High Speed Rail (HSR) trains per hour (tph), plus up to 8 Caltrain tph, into the proposed "train box" design for the Transbay terminal, which has 3 island platforms with a total of 6 platform tracks.

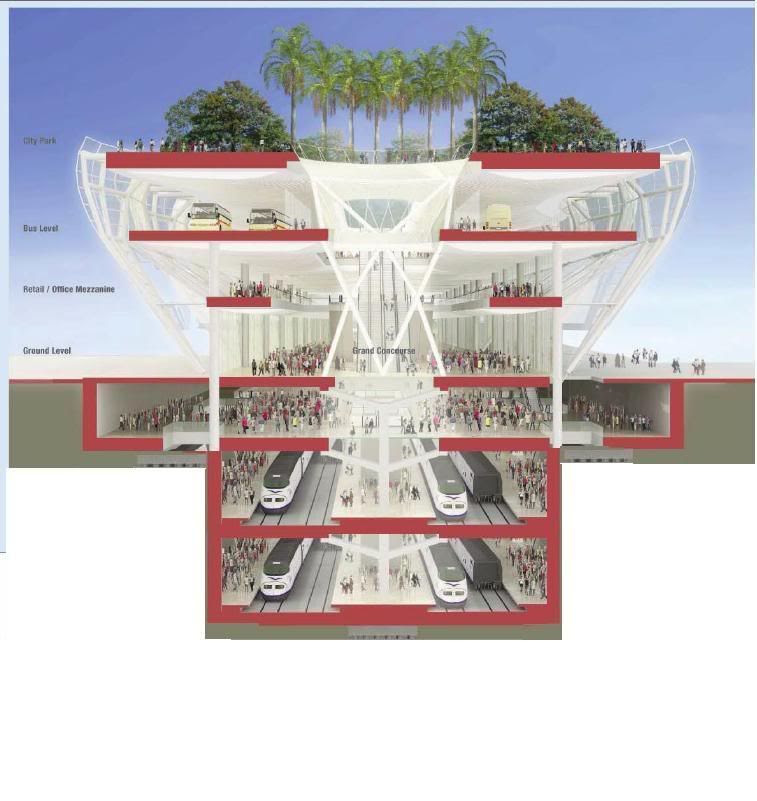

Cast of Players

The Transbay Terminal is a transit/development project, so they have their own organization, the Transbay Joint Powers Authority. They have a staff of seven, including a principle engineer.

The California HSR Authority (CHSRA), is the small commission that has been responsible for pushing the California HSR through the planning phase. According to their testimony at the meeting (I think it is the executive directory, Mehdi Morshed), two years ago, they were pushed into doing everything possible through contractors, and they only have a staff of three, and it would seem do not have a principle engineer. They are also completely broke ... they have been running on IOU's to their contractors, because of the California state budget crisis, and are waiting on bond sales to be cleared to be able to actually pay some bills.

Caltrain is the rail service that runs between San Jose and San Francisco on right of way and track that was bought from a former private owner. They operate under a board of directors with three members representing the city and county of San Francisco, three members representing the San Mateo County, and three members representing Santa Clara County.

So north to south along the Caltrain line, that's San Francisco, Silicon Valley (San Mateo County), and San Jose (Santa Clara County). The representative from San Mateo and Santa Clara are from area transit authorities.


Why 8 HSR tph

Why 8 tph? I argued that 6 trains per hour could well be the commercially desirable mix of services when the San Diego stage opens.

This is of course a "peak" in the service schedule. That is, if a "regular" middle of the day schedule is 3 trains per hour, that implies about 6 trains per hour during the period of peak demand for intercity travel.

Beyond that, are special services, a possible extension to Las Vegas, the "commuter overlay", possible complementary Rapid Rail services along the coast ... all of which ought to be able to take advantage of the investment at the TBT in intermodal connections to BART and Bay Area buses ... and indeed, some of which would be taking advantage of the intermodal connection with Caltrain.

Which is how I arrived at 8tph as a target ... a foreseeable peak number of services, plus capacity for two more, for further expansion of rail services.


On Squeezing a Size 8 Schedule in a Size 6 Train Box

The California HSR Authority has requested an assured 40 minutes at the platform for their services. In overseas European HSR experience, this is a little short for HSR turn-around, but there is at least one German service that has operated on a 34 minute turn-around. Given the extreme operational inflexibility of the proposed train station design, best overseas practice plus six minutes for contingencies ... a medical emergency, a deep clean of a seat, swapping out a broken coffee maker ... seems to be a reasonable request.

8 trains trains per hour at 4 platforms means 30 minutes at the platform, including time for train movements.

However, in the abstract, 40 minutes at the station can be squared with under 30 minutes at a platform by having the trains "somewhere other than the platform" for the "extra minutes". Part 1 was chasing down the possibility of using the "tail tracks" included in the original design (red lines in above map of tunnel track route) as that "somewhere else". Trains would arrive at a dedicated arrival platform, then move to the tail track for restocking food and drinks, taking out the trash, etc., then move to a dedicated departure platform, then leave.

Standing between the abstract and the real are the limits of the site itself. There are building foundations in the way of connecting the outermost track to the tail tracks, and swapping the HSR platforms around to the innermost tracks looks very much like a design problem without an effective solution.

So ... under an assumption of 8 tph for the HSR, and the platform dwell requested by the California HSR Authority, more than four platforms are needed.


A Puzzle Box

OK, so here's the train box ... where to put two extra platforms?

One idea is to put them on the Mezzanine. Now, this would make the Mezzanine skinnier, so it may require re-arranging the access ... but, following Focus on: SF Transbay Transit Center (Clem at the Caltrain HSR Compatibility Blog):
The dominant pedestrian flows, especially for Caltrain, come from the center of San Francisco, which lies along the flank of the station (unlike traditional European terminals, which are often oriented toward the city center). Vertical access to the station platforms should be oriented perpendicular to the station, towards Market Street, to make use of the inherent horizontal reach of stairs and escalators to bring passengers closer to their destinations. Funneling all passengers through a grand entrance, concourse, fare gate, etc., all along the skinny axis of the building, while perhaps architecturally spectacular, does nothing for passenger throughput. Caltrain monthly pass holders need to get from the street to the platform, pronto, without any scenic detours.


... so abandoning the grand entrance along the long axis of the Mezzanine may not be that bad.


As well, bringing the Caltrain Platform up to the Mezzanine allows for passenger access and egress all along the platform. If Caltrain is to be limited to only two platforms at what is hyped as the "Grand Central Station of the West", at least give their passengers convenient access to those platform.

So under the "Caltrain on the Mezzanine", a Grand Entry could be replaced by escalators and stairs, aligned along the short axis, with access available at either end. One side can be a "main" Caltrain access, with manned information and ticket booths and assistance for passengers with special needs, and the other side a secondary Caltrain access, with automatic ticket machines and platform gates. In between would be the HSR section.

There is, however, something sacrificed in this option. The current plan seems to be to defer the tail tracks until some later date. And one way to increase the operational flexibility of the station is to replace the tail tracks with a loop that extends underground back to the original rail tunnel tracks ... so that departing services do not have to fight for tracks with arriving services.




This "Caltrain on the Mezzanine" approach closes off both of those options ... neither trail tracks or a loop back track is possible, since the Mezzanine does not extend the full length of the train-box. The balance of the space at that level is occupied by a Greyhound terminal.

"Caltrain on the Mezzanine" would certainly represent an increase in the cost of the train-box, since the Caltrain services will require more headroom than the Mezzanine currently provides for. Still, adding that additional height to the Mezzanine level seems like the least expensive way to bring the TBT train-box up to spec.


Hit the TBT with a Two by Four

The Caltrain on the Mezzanine shifts the squeeze from the main platform level onto the Mezzanine level.

So, what is the impetus to squeeze? Well, the deeper you dig, the more expensive. Indeed, the cost projection on the TBT says $390m to include the original train-box as part of the original foundations, $490m to add the original train-box later, and an incremental $300m to $700m to add a second, three island level to the train box.

The "Two by Four" option tries to economize on the cost of digging deeper by narrowing the box ... instead of "Two by Six", six platform tracks at three island platforms, duplicated on two levels, four platform tracks at two side platforms and one island platform, duplicated on two levels.

With the original train box, three rows of support columns have to run through the train box to the foundation, to support the building above. With the "Two by Four", only the central row of columns is required, with the outer rows of support columns sitting above the side of the box.

One advantage of this layout is that if the Caltrain platforms are located at the central island of the top level, the option of later extension to tail tracks or a loop-back track is retained.




With four platforms at two levels, it is also possible to remove some the cross-service interference. If the split between upper and lower tracks occurs at the top end of the tunnel under 2nd street, the there could be an access track and an egress track for each level, with the switching from the tunnel tracks to the platforms as short as possible, to reduce the time that one train movement blocks another platform.

And of course, with two levels, a train movement at the top level will not interfere with a train movement on the bottom level. Suppose that the train movement plus safety separation is 3 minutes. Then 8 HSR tph and 8 Caltrain tph can be scheduled to arrive across an hour as:

:00:03:06:09:12:15:18:21:24:27
C#1H#1C#2H#2freeC#3H#3C#4H#4free

:30:33:36:39:42:45:48:51:54:57
C#5H#5C#6H#6freeC#7H#7C#8H#8free


With this schedule, as long as the HSR services heading to one of the two top level platforms are scheduled in one of the "even" slots, there is space in the schedule for the HSR service to arrive, then a Caltrain service to clear the platform, then the next Caltrain service to arrive on that platform. While this is a constraint on flexibility, four out of six HSR platform tracks can operate with no interference at all with the Caltrain services.

There is another project cost saving in this design, as it fits comfortable with one access track and one egress track for most of the length of the tunnel, as described in Focus on the Transbay:
Oversized DTX Tunnel. Despite the high level of train traffic, a simple two-track tunnel into the station would do just fine. Because trains are limited to the same homogeneous speed by the sharp curves, a two-track tunnel could easily support 15 to 20 trains per hour, each way, or far more than the terminal could feasibly handle. The third track makes the tunnel needlessly expensive, and requires fancy construction techniques like the New Austrian Tunneling Method (NATM).


A two track tunnel also provides some minor easing of the problem of the very tight curves in the original design:
While curve radii at the location of the TTC itself are dictated by the street grid and surrounding building foundations, the two curves in the DTX tunnel approach (to turn from 7th onto Townsend and from Townsend onto 2nd) are much sharper than they need to be, and beyond the capability of some off-the-shelf high speed trains. High speed trains aren't MUNI street cars and won't turn on a dime; they are longitudinally stiff to provide good stability at high speeds.


In addition to the overall placement of the curves in the access tunnel, part of the tight radius of the curves is the (expensive) design decision to provide a three track tunnel. So shifting to a two-track tunnel, can also help ease the very tight curves in the original TBT design.


How Much is Enough?

As discussed in Part 1, there would seem to be substantial efforts on the TBT side to "talk down" the capacity that needs to be provided, as well as sidestep the problems in actually using the train-box as originally designed, in order to avoid being on the hook for a more expensive train box.

However, the current discussion is in the context of applying for Federal stimulus funds allocated to rail projects. If it is possible to design a better train-box, it would surely be possible to apply for the funds to build that train-box. If an inadequate train box is built because there was no way to obtain the funds for a better one, that is one thing. If an inadequate train box is built because of a refusal to apply for the funds to build a better one, that seems far harder to excuse.

Saturday, March 21, 2009

A Train Station Grows at Transbay ... Hopefully not a Bonsai (pt. 1)

Crossposted at Progressive Blue, Docudharma, The European Tribune, and soon at Agent Orange.

Burning the Midnight Oil for Living Energy Independence

I was able to get an interesting look into the proposed future of Intercity Travel in the Bay at the Transbay Terminal (TBT) in San Francisco.

Senate Info Hearing on High Speed Rail in California

Note that I am not trying to give "objective reporting" on this issue but rather to give vent to my reaction to watching the hearing online ... see The Troubling Discord Between Transbay and High Speed Rail Authorities for a less hot under the collar reaction.

One piece of information is that in California, when one public authority has the funding for sufficient staff and another doesn't, and it comes to a fight, it is considered fair game for the staffed up authority to toss up spin and red herrings and biased analyses, confident that the other authority does not have the capacity to answer promptly.

Late on in the piece is the technical guy from the Transbay Terminal (TBT) project putting in all sorts arguments against changing the design of the TBT "train box", without concern or regard for whether the arguments would be considered fair or impartial by a disinterested third party. He compared:
  • the station stopping time at a through platform to the station stopping time at a terminal platform;
  • the terminal turn-around for a regional rail service running between San Jose and San Francisco with a long distance rail service for a train that arrived from Anaheim/LA (or even, in Stage 2, San Diego); and
  • the number of services on single routes in Japan and Europe with the number of services for the main northern terminal for multiple routes in California


He wasn't the only one with tricks up his sleeve ... one of the Senators asked after the terminal capacity at Anaheim. The answer, by the way, was six platform tracks for what is supposed to be the secondary Southern Terminus when the full system is complete ... two more than the TBT proposes for HSR, at what is supposed to be the primary Northern Terminus.


How many HSR services should be allowed for?

On the other hand, the California High Speed Rail Authority (CAHSRA) seems to be making claims that are difficult to support. They seem to have asked for an ability to support 12 trains per hour (tph), with 40 minute platform dwell times, claiming that they need 9 to 10 platform tracks.

First, the basic math ... 12tph with 40 minute platform dwells, inclusive of headways, is 8 platforms.

More fundamentally, though, where are 12 trains per hour coming from? That is a technical requirement for through stations, because the HSR line is designed to permit trains to pass at five minute intervals, and along the line, you cannot allow one service to block the next in line.

For the terminal station, the question is the number of services that might start or end at the station. For the California HSR system:
  • LA and the Bay is the backbone transport market for the HSR system ... there could well be demand for one LA/Anaheim Express and, half an hour later, one LA/San Diego Express
  • Running Express Routes drops off very useful trip pairs, so there will be demand for a Semi-Express, and the likelihood is that the hour that supports two Bay/LA Express services will support a Bay/LA/San Diego Semi-Express.
  • The Central Valley will be within three hours by an all-stops HSR to both LA and the Bay ... and within two hours of one, the other, or both. So in addition, one all-stations LA/Anaheim HSR service per hour providing access to and from the CV ... bearing in mind that while this is a smaller transport market, the HSR will grab a larger share of the total market


So this is 4 trains per hour ... 1 train per hour on four distinct services ... without even considering a Fresno special, or a spur at Mojave for Las Vegas.

And when the 400 seat single level, single set trains start filling up, its better for building ridership to increase frequency than to increase capacity. 2 LA/Anaheim Expresses per hour, split the all-stops CV into Express Fresno then all-stops to LA and all-stops to Fresno and Express to LA, and a mix of Express LA/San Diego and Express to LA then all stops to San Diego, and we are already at 6tph.

Indeed, as blogger DoDo on the European Tribune notes, the service schedule that the HSR ridership modeling is based upon (pdf) implies up to 8 trains per hour at the TBT.

Twelve trains per hour may be aiming too high, but six trains per hour clearly risks aiming too low.

Given the massive cost of building more capacity after the original foundation has been laid, the capability for eight (8) HSR trains per hour seems to be a perfectly reasonable expectation for the primary northern terminus for the system.


Following the trail of red herring

Now, when someone deploys deceptive comparisons and unbalanced comparisons, I have a reflex reaction ... a pile of red herring is normally used to cover something up.

And that something seems to be is a design flaw.

The TBT "train box" includes two "tail tracks", allows trains to get off the platform, either for overnight parking or for non-passenger operations like restocking and cleaning, without using up space in the tunnel.

What this means in theory is a train can arrive at an arrival platform, unload passengers (which is a very quick operation, since trains have far fewer passengers per door than airplanes), move to the tail platform to make room for the next train, get trach unloaded, seats needing deep cleaning looked after, food and beverage restocked, and then get move to the departure platform.

And the TBT tunnel access is designed with three tracks, which eliminates all sorts of potential bottlenecks:
  • Both Caltrain and HSR services arrive in the TBT on the central track
  • A Caltrain service departs from the Caltrain island platform using the "inner" tunnel track, which opens up the platform for an arriving Caltrain service
  • After the departing Caltrain service has left, the arriving Caltrain service switches over to the "inner" track to get to the Caltrain island platform
  • HSR services run directly to the central arrival island
  • Passengers depart the HSR services, the train goes to the tail track for restocking and to clear the platform for the next service, from the tail track to the departure platform, then depart using the "outer" tunnel track


This is a system that allows three different islands to be accessed with little interference, because only two islands receive incoming trains, and because each type of service has its own dedicated departure track ... so they can arrive in sync, dwell in station for different lengths of time, and leave on their own schedule.

In particular, it allows the HSR trains to be in the station for over 40 minutes, while only occupying the platforms for 30 minutes each, raising the capacity of four platforms from six trains per hour to eight trains per hour.

This also makes it easier to organize efficient movement of passengers, since passengers are either leaving or arriving at each HSR platform ... there isn't a the problem of departing passengers getting in the way of arriving passengers.

With this approach, 4 platform tracks support 8 trains per hour ... which is to say, adequate to the needs of the planned HSR system with enough spare capacity to allow for some growth.


The Design Flaw



The design flaw ... for supporting 8tph, that is ... may not jump out at you, but its in the picture, taken from the 2003 "locally preferred option" design for the TBT Environmental Impact Report. The right hand side is the tunnel from the present end of the rail line. The left hand is the turn to the tail tracks.

Now, the HSR platforms have to be designed for long trains ... once the capacity is filled with 8 car, 400 seat trains, they can be extended to 16-car, 800 seat trains, and then by moving to bi-level trains, 1400 seat trains. That means a 1,320 foot long platform. That means that the bottom two islands are for the HSR and the top island is for Caltrain. The bottom two platforms need to be stretched a bit, and the middle one straightened somehow ... but the TBT technical person said that that had been fixed up.

So, stepping through the pictured design:
  • Counting access tracks, three tunnel tracks split up to make six platform tracks. So far, so good.
  • For Caltrain to operate as described above, a switch will have to be added so Caltrain services can get from the middle tunnel track to the "inner" tunnel track which leads to the Caltrain platform. And since the outbound train has to leave the Caltrain platform before the inbound train can arrive, that will work just fine.
  • The two Caltrain platform tracks are connected directly to the Caltrain exit track, so that will work just fine.
  • For the HSR trains to operate as described above, the central island is the arriving platform, connected directly to the tunnel track that brings trains in. That will work just fine.
  • That leaves the bottom island as the departing platform. The two platform tracks at this island are connected directly to the HSR exit track, so that will work just fine.
  • And the tail tracks ... are not connected to the bottom platform track. Instead, the bottom platform track comes to a dead end. That is not just fine. Indeed, assuming that the TBT has the staff that they likely know all of this already, that might be what the pile of red herring is supposed to cover up.


What can be done to straighten up the mess? One approach is to swap the Caltrain platform from top to bottom ... and trim a substantial piece from the front (right hand side) of the bottom platform. In fact, trim enough from the front that the switch between the two platform tracks is after the single tunnel track has rounded the corner.


Note that this is just a rough sketch

Trimming off the front of the bottom island allows the middle island to straighten up. Straightening up the middle island allows the top island to straighten up.

The middle island can be straightened up a bit by extending the tail track directly from the middle platform, with switches connecting the top island, which gives more room before the platform track must bend to form the rail track.

This might not be enough for 1320 ft. of straight platform, but it'll be a lot closer ... and, after all, the CAHSRA is probably overstating how much straight platform they need, since the platform only needs to be straight for the passenger car portion. A little bit of bend for the driver cars at the front and rear of the train can be tolerated. If this can get 1200 ft. of straight platform with a 60 ft. curved part on either side, that certainly seems like it ought to be OK.


So, if both sides are wrong, who is going to admit it?

The question that puzzles me the most is not the technical one ... as tight a squeeze as it may be ... but the political one. The TBT authority have made public claims that present a picture of basically being ready to go, except for the fantastical demands of the CAHSR authority. The CAHSR authority has made fallen into the trap of making an ambit claim that they will have to strain to support ... but if that costs them the political argument, the fact that the TBT train box is an inadequate design is likely to be lost in the collapse.

The only player that strikes me as having the opportunity to say, "wait a minute, here's a fix that won't cost all that much to implement" is Caltrain. But ... under the solution above, they are giving up a 900 ft. platform, connected to the tail tracks, for what could end up being a 800 ft. platform, with only one connection to the tail track, and that connection only available when the closest HSR platform track is empty.


To Be Continued ...

Anyway, that's the puzzle. But there's another possibility ... one which might be of more appeal to Caltrain ... so I am going to end this with an ellipses.

...
